What is cost to schedule allocation?
This is the process of creating a relationship between a project's budget and schedule therefore assigning value to each day of a project.
__
Key terms
|
Planned Value or Planned Revenue |
The amount of budget allocated to a day of future work. |
|
Earned Value or Earned Revenue |
The amount of budget allocated to a day of completed work. |
|
S-Curve (see image below) |
The projected path of costs over time for a given project or cohort. Usually follows the shape of an “s” because costs are low in the beginning and increase quickly as construction begins. |
__
Why did we do this?

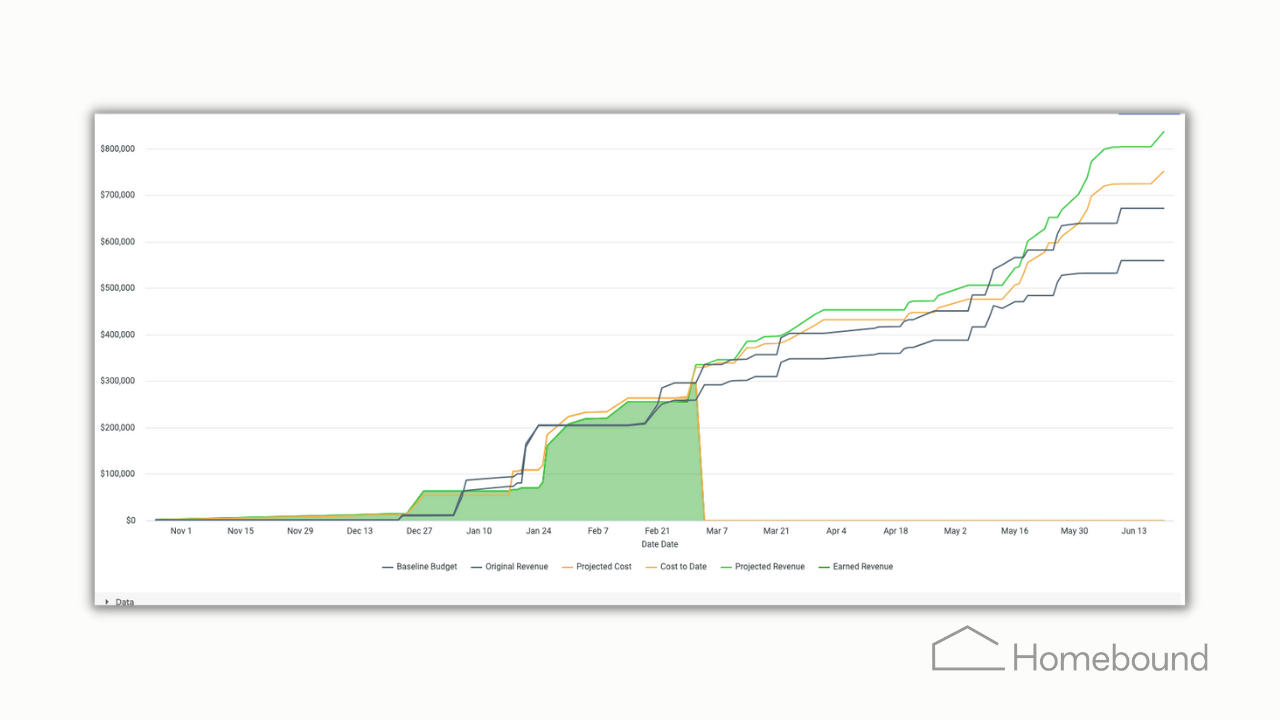

Once costs have been allocated to the schedule, we are able to produce readouts on Earned Value Management (EVM) which is a budget and schedule management tool. The visualization of this (developed by our data team in Looker) is known as the s-curve (see image below).
It has the added benefit of being a forecasting tool that the Finance Team and Homebound Leadership Team can rely on for reliable revenue projections.
EVM will allow anyone at Homebound to answer these questions:
- Is this project ahead or behind schedule?
- When is this project likely to be completed?
- Is this project currently over or under budget?
- How much will this project be over or under budget when it is complete?
- What are the schedule and budget trends, and what can we do to adjust?
- What is the remaining work likely to cost?
- How efficiently are Homebound’s resources being used?
- How efficiently is the Project Team using their time?
__
4 Steps to allocate schedule tasks to cost codes
Step 1:
Add specs and selections to a project. See the article Adding a Spec to Specs & Selections for more detail on this topic.
Step 2:
There are two screens from which allocation can be completed: the schedule screen and/or the specs & selections screen.
Schedule screen:

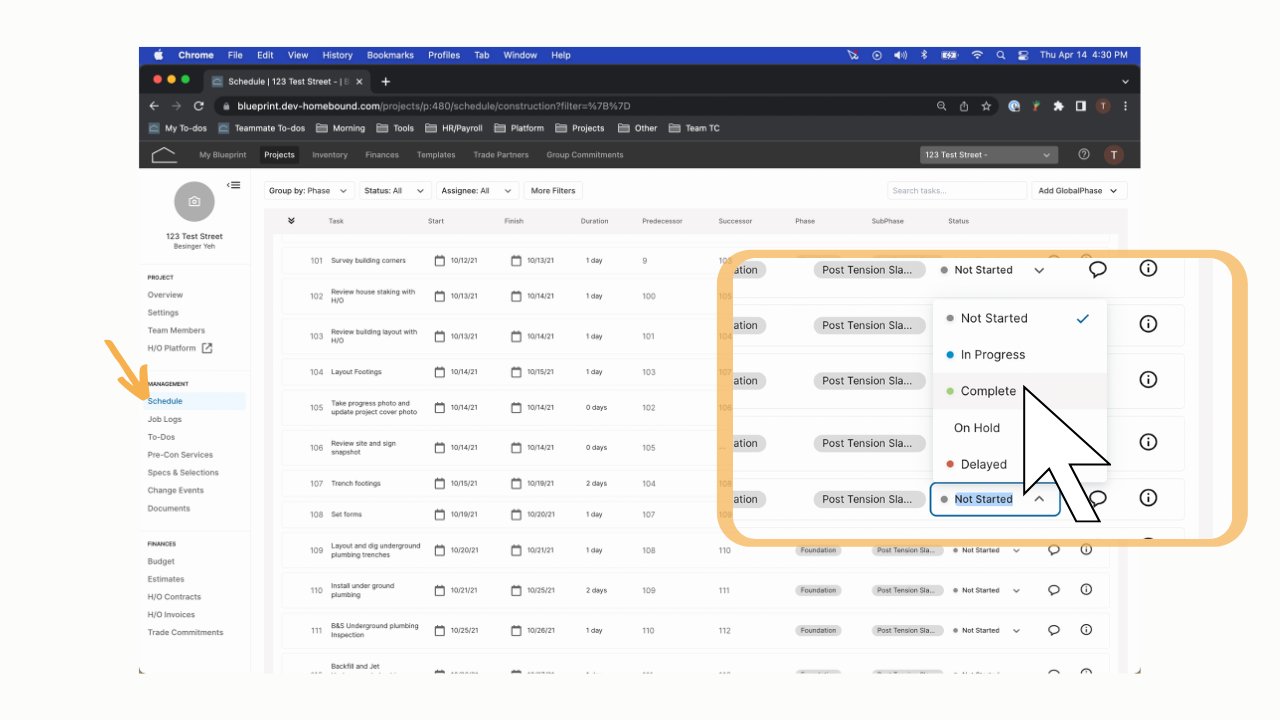

From the schedule screen, click the "i" icon to the right of any task. Within the pane that opens, click "add a Project Item" next to Cost Allocation to assign a cost code to this scheduled task.
Specs & selections screen:

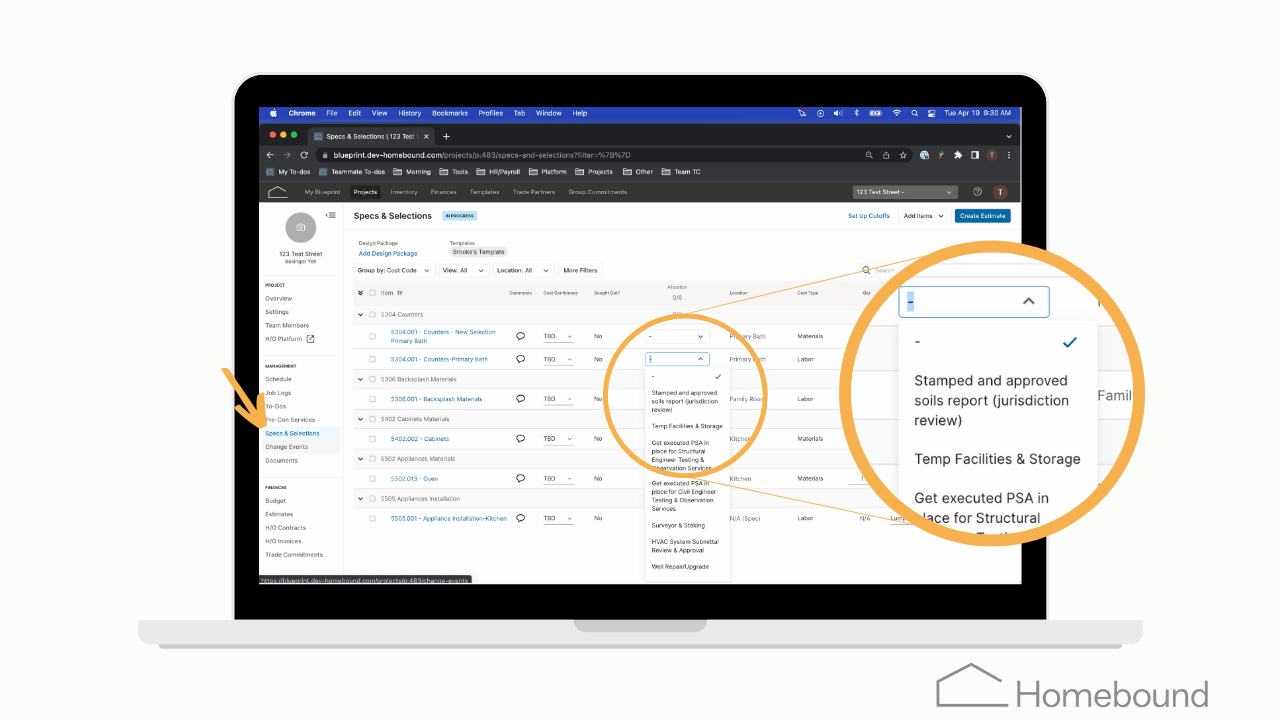

Alternatively, users can allocate line items in the specs & selections screen directly from the table view (see image below). Allocation from this screen is only possible before a construction contract is finalized.

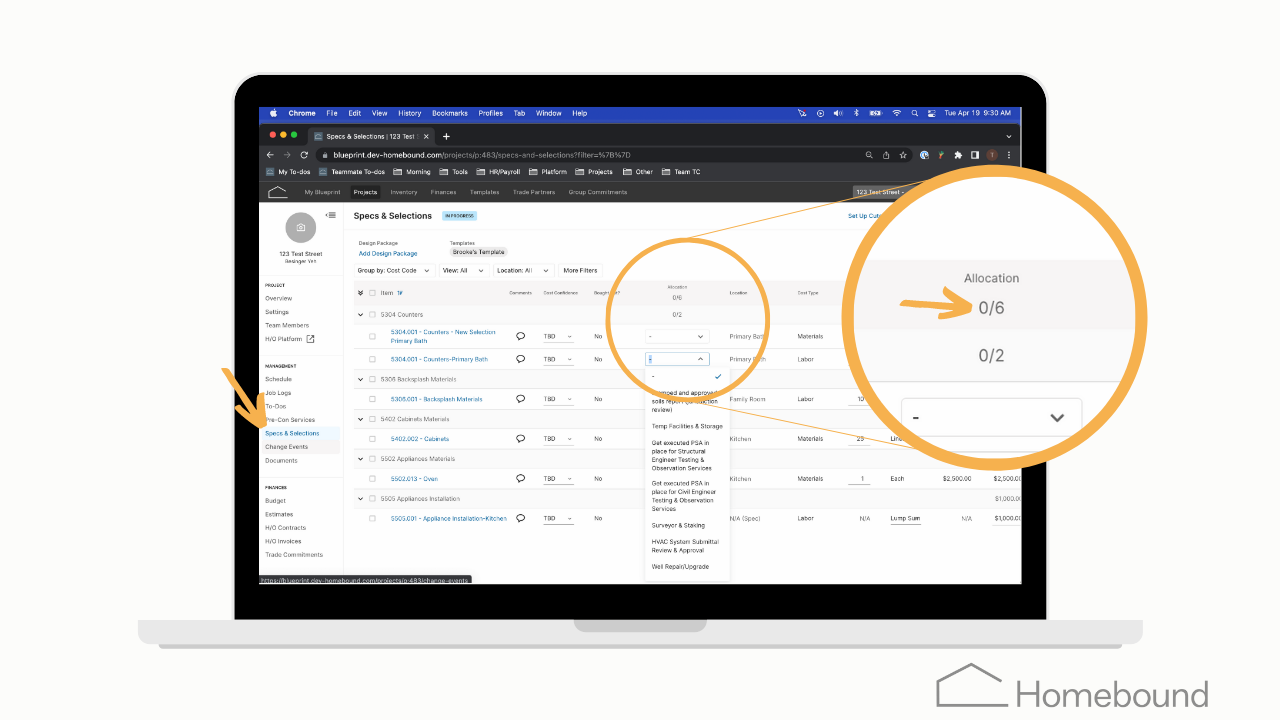

Note: Ensure that allocation is complete by reviewing the "Allocation" column in the Specs & Selections screen (see image below).
Step 3:
Adjust the status in schedules to reflect when tasks are completed in order to recognize earned construction value.
Step 4:
Reach out to Product Operations for assistance replicating allocations across like projects.
__
